Audits

Plan and run a real compliance audit from end to end — name the engagement, pick the controls it will test, assign a lead auditor, and move it through its lifecycle from planning to closure.

An audit engagement (a planned exercise that checks whether a set of controls really work) is the live record of an audit you are running or preparing for. Each engagement carries a name, an optional date range and report-due date, a lead auditor, and a scope — the framework controls the audit will test. Every control in scope becomes one plan item: a single control under test, with its own tester and status. The engagement therefore doubles as the checklist of work to be done.

The screen lives at /compliance/audits, but its menu entry sits in the AUDIT group in the left menu, alongside Mock Audit, Benchmarking and Audit Log. It is not the same as Audit readiness, which scores how prepared you are; Audits is where you run the engagement itself.

This chapter is the screen-by-screen reference. To see the preparation for a real external audit worked as a story — evidence, policies, rehearsal and the audit week itself — see the full walkthrough in Scenario: prepare for an external audit.

Who uses it

Access follows your role, and the permissions differ enough that two people can look at the same audit and see different buttons.

Role What you can do here
Viewer Read-only: open the list, filter it, read any audit's status, metadata and plan items.
Contributor Everything a Viewer can do. Contributors are the testers — they hold the fieldwork (“conduct”) permission, so they can assign a tester to a plan item and move its status forward directly in the plan-items table. No New audit button.
Manager Create an audit, change its status along the lifecycle, and delete it. Managers also hold the fieldwork permission.
Admin Everything a Manager can do.

Audits also needs the Compliance module switched on for your organisation, because the route sits under the /compliance prefix. If it is not switched on, the Audits entry drops out of the AUDIT group and the route itself is blocked.

What's on this screen

The Audits list is deliberately plain. At the top-left sits the page heading Audits with a one-line description of what the module is for. For a Manager or an Admin, a navy New audit button sits at the top-right of that same row; the screenshot below was taken as a Contributor, which is why no create button is there.

Under the heading is a two-control filter bar: a Search audits... box that matches on the engagement name, and an All statuses dropdown that narrows the list to a single lifecycle stage.

Below the filter bar is the list itself. In the capture there are no audits yet, so instead of a table you see the empty panel — a shield icon, the heading No audits yet and that same one-line description repeated underneath. A Manager or an Admin also gets a New audit button inside the panel itself. Once engagements exist, a table with six columns takes its place: Name, Status (a coloured badge), Framework, Lead auditor, Plan items (how many controls are in scope) and Period. A pagination row then appears at the foot with Page 1 of 1, Previous and Next, the buttons greyed out while there is only one page.

Find your way to the list and filter it

  1. Open the AUDIT group in the left menu. The group expands and reveals its pages, including Audits; select it to land on this screen.
  2. Type part of an engagement's name into the Search audits... box. The list re-queries shortly after you stop typing and jumps back to the first page of matches. The search matches the name only — not controls, not auditors.
  3. Choose a stage from the All statuses dropdown — Planned, Scoping, Fieldwork, Reporting or Closed — to show only engagements at that stage.
  4. Read the panel below. With no audits at all it reads No audits yet, as in the capture. If audits exist but your filters exclude all of them, a shorter message appears instead: “No audits match the current filters.” Clear the box and reset the dropdown to bring the table back.

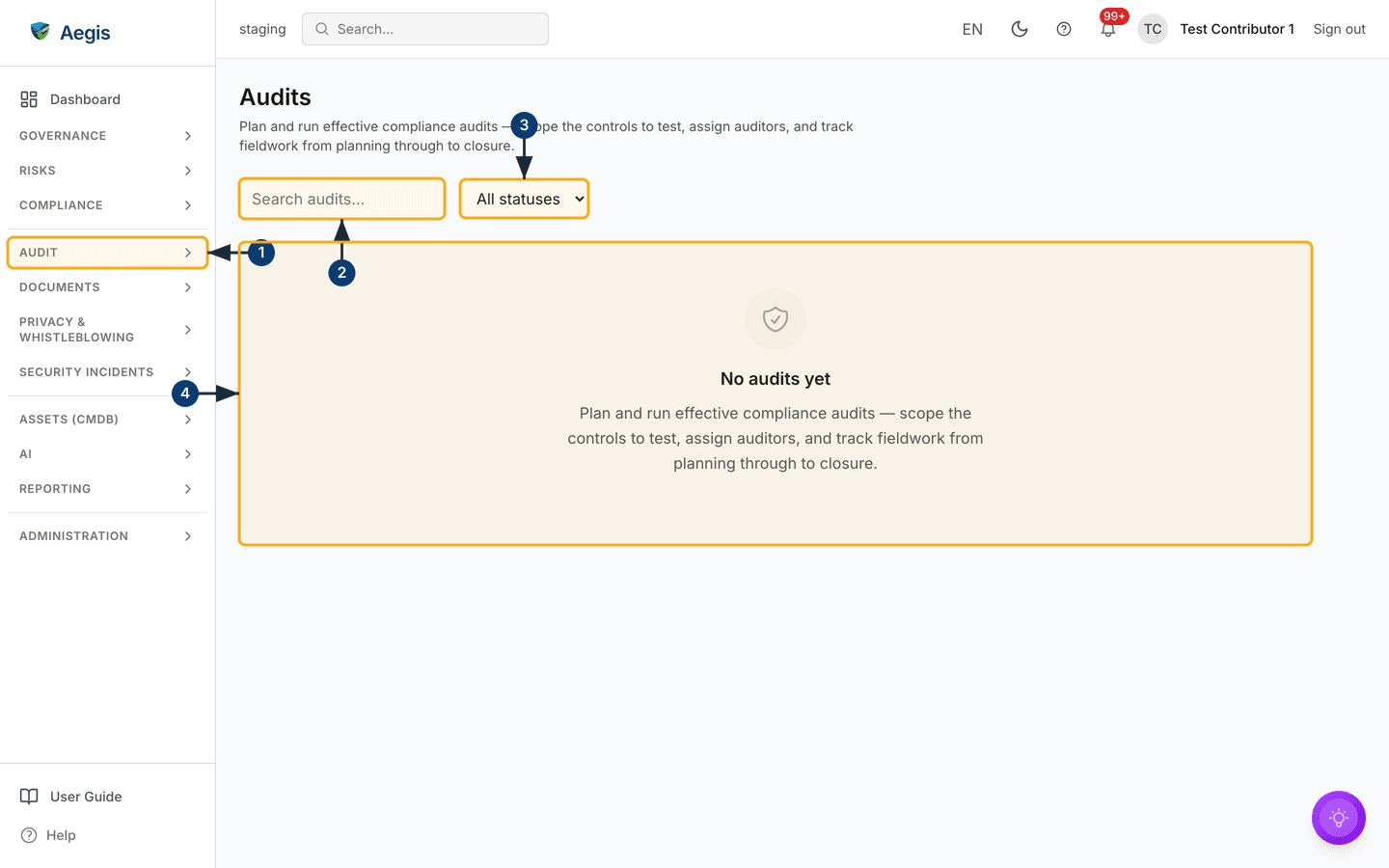

The Audits list as a Contributor, before any engagement exists — /compliance/audits.
The Audits list as a Contributor, before any engagement exists — /compliance/audits.
Opening an audit once the table has rows

Each row is clickable across its whole width, and the name is also a link. Either one opens that engagement's detail page, with its status control, metadata block and plan items.

Create an audit

Creating an audit is a Manager or Admin task. It opens a full page at /compliance/audits/new rather than a side panel, because the scope picker needs the room. No capture of this form is included in this chapter — follow the steps against the live page.

  1. Select New audit at the top-right of the list. The create page opens, headed New audit with the note “Name the engagement, choose its scope and assign a lead auditor.”
  2. Fill in Audit name — the only required field. Leaving it blank and submitting produces the inline message “An audit name is required” and nothing is saved.
  3. Pick a Lead auditor from the dropdown of users. It defaults to Unassigned.
  4. Set Period start, Period end and Report due date if the engagement has fixed dates; all three are optional. An end date before the start date raises “Period end must be on or after the period start” and blocks submission.
  5. Build the Audit scope. The picker lists your enabled frameworks as collapsed groups. Select a framework's name to expand it — its controls load at that moment as a checkbox list, each showing the control reference and title. Tick individual controls, or use Select whole framework in the group header to take every loaded control at once (it turns into Clear framework when all are selected). A running total sits above the groups, for example “12 controls selected”. There is no keyword search inside the picker in this release; scroll the expanded group to find a control.
  6. Select Create audit. Aegis saves the engagement, confirms with Audit created, creates one plan item per selected control, and takes you to the new audit's detail page. Cancel returns you to the list without saving.
Scope is by control, not by framework

You choose individual controls, so the engagement is not anchored to a framework record. That is why the list's Framework column can read No framework even when every control you picked belongs to one. The detail page works it out from the scope and shows the framework name there — or Multiple (…) when the scope spans more than one.

Move an audit through its lifecycle

An engagement runs through five stages in a fixed order. The status control sits in its own panel at the top of the detail page: the word Status, the current stage as a coloured badge, and a button for each stage you may move to next.

Status Badge colour Meaning
Planned Slate The engagement exists; its scope is still being worked out.
Scoping Amber In-scope controls are chosen and plan items are being prepared.
Fieldwork Blue Testers are working through the plan items.
Reporting Indigo Fieldwork is finished and findings are being written up.
Closed Emerald The engagement is complete and kept as a record of the work done.
  1. Open the audit from the list. The status panel is the first thing under the engagement name, with the current stage shown as a badge.
  2. Select the button for the stage you want — the label spells it out, for example Change status to Fieldwork. Aegis saves the change, confirms with “Status updated to Fieldwork”, and the badge and the available buttons both refresh.
  3. To enter Reporting from Fieldwork, every plan item must first be Completed, and there must be at least one. Until then that button stays disabled and an amber note reads “All plan items must be completed before reporting.”
One step at a time, in either direction

You can step back to correct course — Reporting back to Fieldwork, or Closed back to Reporting — but you can never skip a stage. Only the adjacent stages are offered, and the server checks the move again when you save. Roles without the update permission see the badge and no buttons.

Read the plan items

Under the status panel sits the metadata block — Lead auditor, Framework, Period and Report due — followed by the Plan items section, headed with the note “One control under test per row.”

Each row shows four things: the Control (its reference, then its title), the Framework that control belongs to, the Tester assigned to it (or Unassigned), and its StatusNot started, In progress or Completed. If you created the audit without selecting any controls, the section shows a single notice instead: “No controls are in scope yet. Edit the scope to add controls.”

If you hold the fieldwork (“conduct”) permission — Contributors, Managers and Admins do — the Tester and Status cells are drop-downs rather than plain text. Pick a person in the Tester drop-down to assign them to that control (or pick Unassigned to clear the assignment), and move the item through Not started, In progress and Completed in the Status drop-down as the fieldwork progresses. Each change saves immediately, confirms with “Plan item updated”, and is written to the audit log with the values before and after. Once every item reads Completed, the Change status to Reporting button on the status panel unlocks. Without the permission the cells stay read-only: the tester as plain text and the status as a coloured badge.

Delete an audit

  1. Open the engagement you want to remove. For a Manager or Admin, a red-outlined Delete button sits at the top-right, level with the audit name.
  2. Select Delete. A confirmation dialogue asks “Delete this audit? This cannot be undone.” Choose to confirm and Aegis removes the engagement, shows Audit deleted, and returns you to the list; cancel and nothing changes.

Tips and limits
